Wind business across the Middle East and North Africa, charted every week.
Projects, tenders, financing and grid connections from Morocco to Oman and Türkiye. Every figure sourced, every opinion labelled.
The weekly, in your inbox
About this chart
- Isobars every 2 hPa, with air moving along them.
- Each station's dot fills with the reports we hold; its barb shows illustrative wind.
Chart of 13 October 2026. The pressure pattern is illustrative, not a forecast.
From Morocco's Atlantic coast to Oman's Arabian Sea, we read the wind business from inside the region.
- Reports on file
- 101
- Sources linked
- 143
- Core markets charted
- 8
- Posts every weekday
- 2
Latest observations
Open any report to read it here, sources included.
Four years after the grant, the EIB awards a EUR 1.99 million feasibility contract for Morocco's offshore wind
The EIB contract for studies on a planned 1 GW project off Essaouira runs for up to 43 months, while construction is targeted to start in 2029. 1 min read
Four years. That is how long it took to turn an EIB offshore wind grant for Morocco into a consultant contract.
In September 2022 the EIB and Masen, Morocco’s sustainable energy agency, signed a cooperation agreement with a EUR 2 million grant for an offshore wind feasibility study off Essaouira. MEED reported on 3 September that the EIB has now awarded a EUR 1.99 million contract for the feasibility and environmental studies on a planned 1 GW project. Eleven firms bid. Ten were registered in the European Economic Area and one outside it.
Now read the contract terms. It runs for a maximum of 43 months including possible extensions, and construction is targeted to start in 2029. Count 43 months from an award reported in early September 2026 and the window closes in spring 2030. The source does not state the contract start date, so I read this as an open question.
My prediction: the 2029 date moves. The studies can finish early, but I would not plan a supply chain around that. My view is that a 1 GW offshore project that rushes its environmental assessment pays for it later.
It took four years to buy the question.
Which comes first off Essaouira: the study results or the construction date?
ACWA Power is building 1,500 km of line to carry 1.5 GW of Uzbek wind
A USD 3.06 billion package in Karakalpakstan bundles turbines, batteries and five substations. We read the grid scope as what sets the schedule. 1 min read
ACWA Power said construction has started on three wind plants totalling 1.5 GW in Kungrad district, Karakalpakstan, a USD 3.06 billion programme. The package includes a 300 MW battery system, about 1,500 km of high-voltage transmission line, three new 500 kV switching substations and two upgraded ones.
ACWA guides commissioning in Q1 2027. UzDaily reports that ACWA’s Karakalpakstan projects as a whole are expected to generate about 8.77 billion kWh a year. President Mirziyoyev launched construction on 18 September, according to UzDaily. Together with the 300 MW Nukus 1 and 2 plants, ACWA’s Karakalpakstan wind fleet would reach about 2.3 GW.
Why it matters
Wind at this scale now arrives as a bundle of turbines, batteries and transmission. We read the grid scope as the part that sets the schedule.
What it means for MENA
We read this as Saudi capital exporting a full delivery model. In our view it becomes a yardstick for wind-plus-grid packages across MENA.
On the Gulf of Suez, the deadliest part of a wind farm may be the line it does not route
A 2007 bird map still sorts Egypt's best wind land. The EBRD plan for a 550 MW plot puts most of the risk on a 47 km overhead line set by the authorities. 1 min read
Six hundred and fifty six square kilometres of state wind concession on the Gulf of Suez. A government-backed study in 2007 marked 60 percent of it as red zone, closed to turbines because of migrating birds.
That map still sorts the new plots. Suez Wind Energy’s southern 550 megawatt plot landed in the orange zone, where further study is required, beside three plants already in the green, inside an Important Bird Area 100 kilometres long. The EBRD rated the project Category A and is financing the 1.06 billion dollar build with up to 200 million dollars. ACWA Power and HAU Energy are among the sponsors.
Then read the biodiversity action plan. Its estimate for that plot, after mitigation, is 34 soaring birds a year, mostly from collisions with the 47 kilometre overhead line rather than the blades. The EBRD page says line routes are determined by the Egyptian authorities and generally follow existing lines.
Our reading
The developer inherits the wire it will be judged on. We think the market prices this backwards. Wind speed and turbine cost get the models, while the deadliest piece of the project may be the one the developer does not route.
The plan has observers on watch twelve hours a day through 28 October. When the next Gulf of Suez round opens, who prices the wire?
Saudi power awards fell from USD 54.2 billion to USD 3.4 billion. Wind's money is waiting on Round 7
MEED data shows a sharp slowdown in 2026 contract awards. Round 7 bids for 2,200 MW of wind were due in September, but awards may slip into 2027. 1 min read

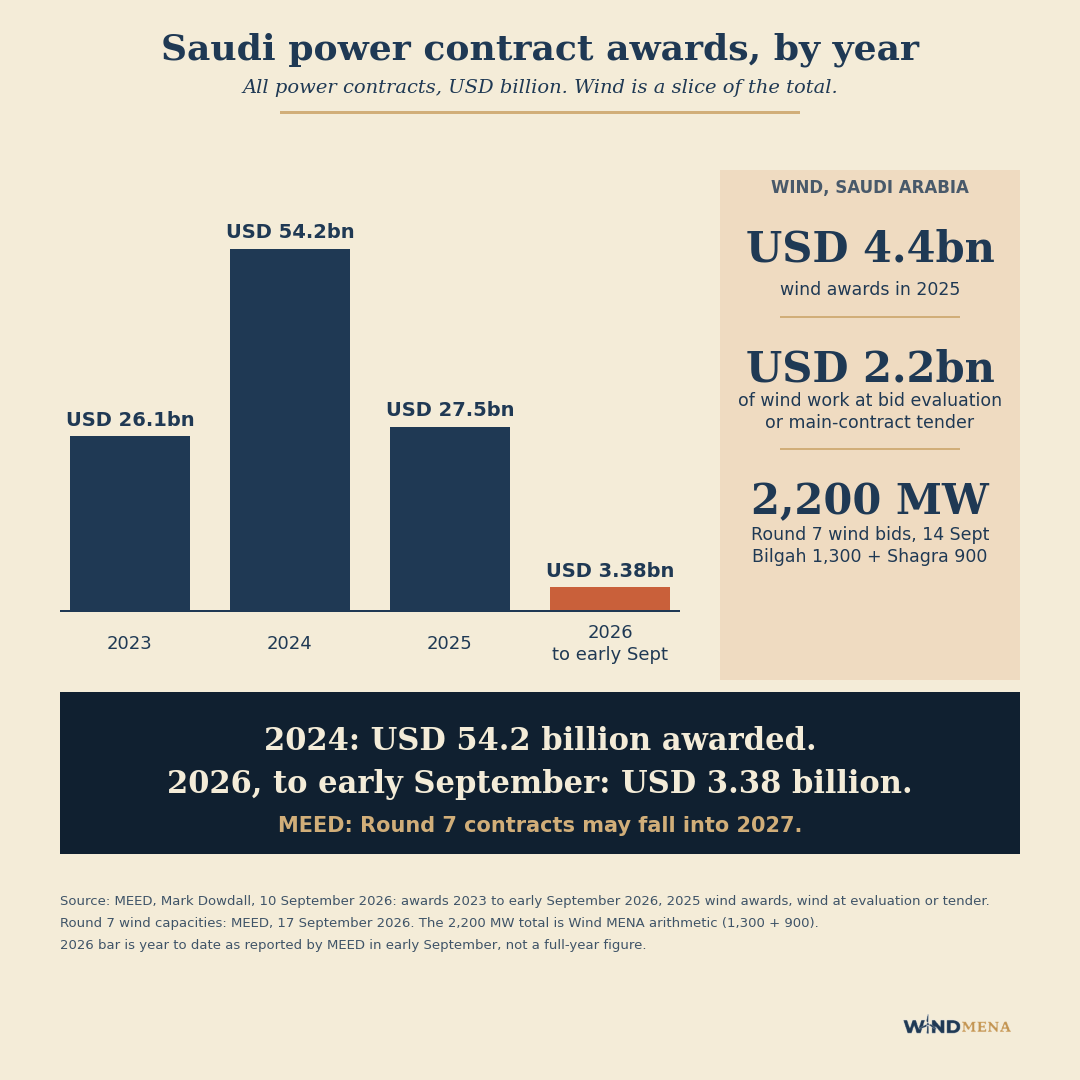

Saudi Arabia awarded USD 54.2 billion of power contracts in 2024. By early September 2026, the year’s total stood at USD 3.38 billion.
MEED’s Mark Dowdall puts 2023 at USD 26.1 billion and 2025 at USD 27.5 billion. Wind took USD 4.4 billion of the 2025 awards, and USD 2.2 billion of wind work is still at bid evaluation or main-contract tender.
Round 7 wind bids were due in September: 1,300 MW at Bilgah and 900 MW at Shagra, 2,200 MW together. MEED says contracts from Round 7 may now fall into 2027 rather than materially lifting this year’s total.
Two cautions. These are all-power figures, with wind one slice of them. And MEED links the slowdown partly to a shift toward battery storage and transmission, alongside Round 7 procurement delays.
Our reading
The wind money is at bid stage, with no awards yet. A bid is a promise. An award is a purchase order, and the supply chain only hears the second one.
Sonelgaz tenders 200 MW of wind in Laghouat and Djelfa, with bids due 25 November
Algeria's only operational wind farm on record is 10 MW near Adrar. The tender lets foreign firms bid alone, requires Algerian firms to partner with a foreign one and includes grid connection. 1 min read
Algeria generates more than 99 percent of its electricity from natural gas, and its entire wind fleet, on IRENA statistics cited by Ecofin Agency, is one 10 MW farm near Adrar. On 30 September Sonelgaz asked the world to build two more, 100 MW each, in Laghouat and Djelfa.
The reported terms say more than the megawatts do. Bids close on 25 November, eight weeks after launch. Foreign firms can bid alone or in consortium. Algerian firms must partner with a foreign one. The scope runs from study and engineering through civil works, supply, assembly and commissioning, with grid connection included.
Two things stand out. First, 200 MW is a third of the 601 MW of renewables Algeria had installed at the end of 2025, per IRENA figures cited by Ecofin Agency. One tender moves the national total. Second, the coverage I found mentions no power purchase agreement, which suggests a build contract rather than a developer-financed IPP. That is my reading, not a confirmed structure.
My prediction: the partnership rule will decide this field before the turbine price does. With eight weeks on the clock, bidders who already have an Algerian partner start ahead, and everyone else negotiates while they price.
In Algeria, the hardest page of the bid may be the partnership agreement.
Will 25 November draw a real field, or only the consortia that formed before the notice landed?
It took four years to buy the question.
The EIB contract for studies on a planned 1 GW project off Essaouira runs for up to 43 months, while construction is targeted to start in 2029.
Read the analysisHow a report gets made
Three steps, every weekday, before anything reaches you.
Signal We watch ministries, regulators, developers, lenders and the trade press across the region every weekday. More
We start from developer and ministry announcements, regulator filings and development bank disclosures, then established energy reporting such as Reuters, MEED and Zawya.
News older than fourteen days does not run as news.
Verify Every name, capacity, amount and date is traced to its source before anything publishes. More
A nine-point check runs before each post: claims against the cited page, working links, no repeat of earlier coverage, and opinion kept apart from fact.
If a claim cannot be traced, we cut it. A skipped slot beats a bad post.
Read Briefs report what happened. Analysis adds our reading, and we label it as ours. More
Each piece asks what a development means for MENA wind: who carries the risk, what it does to price, what to watch next.
When we get something wrong, we correct it on the page and say so.
Stations
Our eight core markets, most recently reported first. Open one to see what we hold. We also follow Algeria, Iraq, Kuwait, Libya, Syria and MENA capital at work abroad.
Morocco 8 reports
- Four years after the grant, the EIB awards a EUR 1.99 million feasibility contract for Morocco's offshore wind
- EIB appoints OWC-led consortium for feasibility study on Morocco's first offshore wind farm
- Morocco's wind output rose 43% in 2024 on 18.5% more capacity, ANRE data shows
- ACWA Power's 40 MW Khalladi expansion is Morocco building on what already works
- Acwa Power wins approval to expand Morocco's Khalladi wind farm from 120 MW to 160 MW
Egypt 23 reports
- On the Gulf of Suez, the deadliest part of a wind farm may be the line it does not route
- Scatec starts 900 MW Shadwan on a bridge loan, ahead of its project debt
- Alcazar signs terms to buy Egypt's 580 MW Gabal El Zeit wind farms from NREA
- PowerChina's Egyptian wind portfolio passes 1.8 GW across three projects
- Alcazar's 500 MW Egyptian wind pair heads for construction before its grid line routing is fixed
Saudi Arabia 8 reports
- Saudi power awards fell from USD 54.2 billion to USD 3.4 billion. Wind's money is waiting on Round 7
- Alfanar puts about USD 100 million more into Senvion India, the wind turbine maker it owns
- Yanbu port lands nine wind turbines, including 27 blades, for Saudi Arabia's Setara and Shaqra projects
- Saudi Arabia's sub-2-cent wind tariff faces its first operating year before Round 7
- Saudi Arabia's 600 MW Al-Ghat wind farm reaches full grid connection on all 80 turbines
Oman 14 reports
- Oman books the world wind conference for December 2027, with two wind farms due first
- O-Green installs a 9.6 MW wind turbine at Duqm to power Oman's turbine factory
- Oman's first wind turbine factory signs a university to train about 321 Omani graduates
- Oman's 125 MW Dhofar II wind farm will free about 76 million cubic metres of gas a year
- Oman tenders a renewables study for Musandam, where peak demand is forecast at 130 MW by 2031
UAE 5 reports
- Masdar and Taaleri open the 154 MW Čibuk 2 wind farm, a winner of Serbia's first wind auction
- Alcazar closes financing on 131 MW Štip wind farm in North Macedonia on an unnamed corporate PPA
- Masdar and RWE agree to consider joint bids in German offshore wind auctions, above EUR 3 billion
- Masdar buys brand-new wind in Spain as Alcazar takes on Egypt's older Gabal El-Zeit fleet
- Masdar turns 20 with a portfolio above 65 GW and a 100 GW target for 2030
Türkiye 10 reports
- Goldwind's 82 MW Manisa order puts its Turkish medium-speed fleet on course to pass 150 turbines
- Türkiye sets its first offshore wind auction for the first quarter of 2027
- Nordex lands a 72-turbine, 525 MW order for Türkerler's YEKA-5 Sivas wind project
- Türkiye's 7 to 11 cent offshore wind band sits over four times above Saudi Arabia's Al Ghat onshore price
- Türkiye opens YEKA-2026 with 1,500 MW of onshore wind across seven auctions
Tunisia 2 reports
Energy Security Index
Compare the region's markets on energy security, scored from public data and updated as new figures are released.
Open the Index
